Projects

Here are a few projects I've worked on.

Construction Progress Chaser

Tool: Power Bi

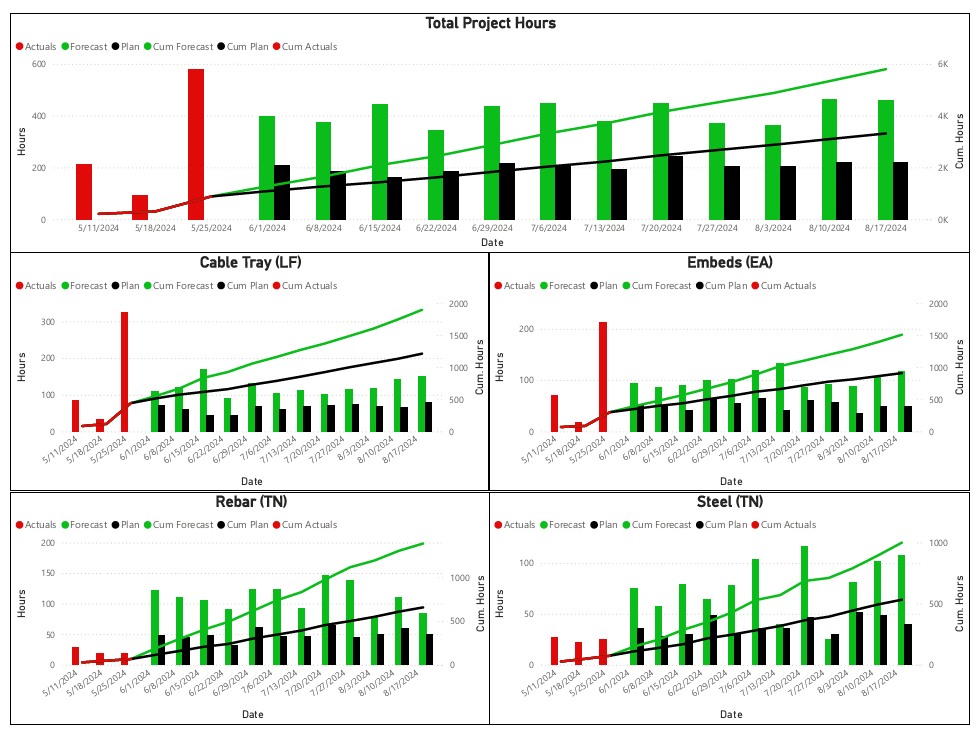

The Construction Progress Chaser is a 12 week lookahead graph that displays forecast quantities and hours compared to a "Plan". Containing over 100+ graphs, the Chaser gets  reviewed by area superintentents and U.S DOE personnel to track construction project performance.


Construction Master Dashboard

Tool: Power Bi

The Master Dashboard displays the in-period peaks and valleys of forecasted quantities and hours by commodity (qtys) and COA (hours). Current performance to date hours and quantities are taken into account in each visual. Complex DAX code was required for normalizing the overall distribution of forecasted hours and quantities to make P6 cumulative forecast data match the budget.

Durations Analysis Data Science Project

Tool: Jupyter Notebook + Power Bi

The purpose of this data science project was to compare our At Completion Duration against our Original Planned duration on multiple Infrastructure projects in the U.S and Canada. Using Python libraries: Seaborn, Matplotlib, Scipy, Numpy, and Pandas; I was able to conduct a comprehensive analysis of those 2 variables by Project, Discipline, and phase of Engineering Design. Regression Analysis was performed to model the relationship between the 2 variables

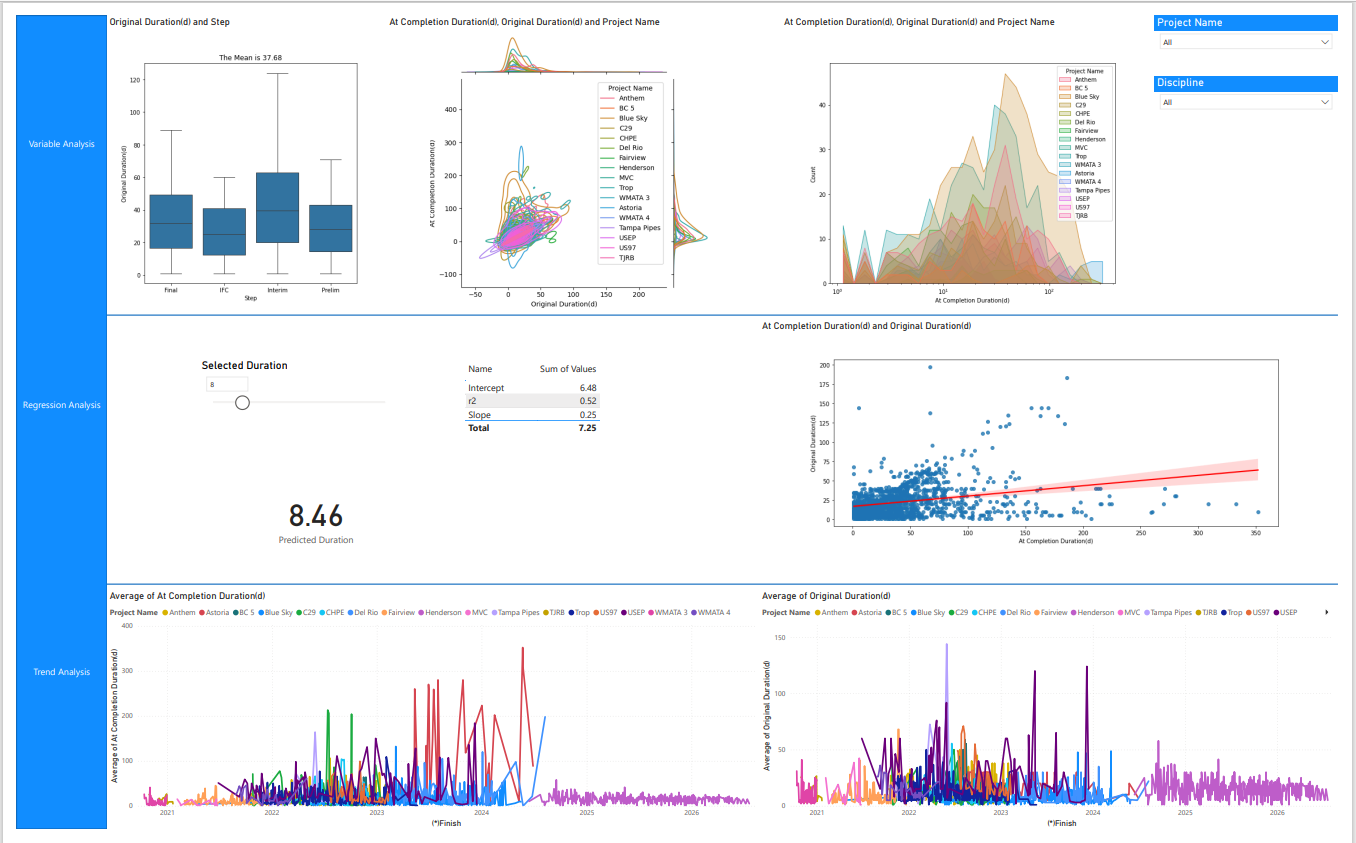

Durations Analysis Python.PNG

Startup to Operations Skyline

Tool: Power Bi

Skylines are very popular in the precommissioning and commissioning phase of a construction project. I developed a skyline to dsiplay the remaining subsystems required to be turned over to operations and how many ITRs need to be completed as a tooltip.

Demo Skyline.png

Vail, CO Bridge Construction Project

Tool: Synchro

A thorough demonstration of how we planned to execute the demolition and rebuilding of the bridge that crosses over Gore Creek allowing travelers to get to and from Vail Ski Resort.

Vancouver International Airport Runway Construction Project

Tool: Synchro

The simulation showcases the construction process of an airport runway, featuring four pavement lifts on both the runway and taxiway. The 4D simulation provides a detailed, hour-by-hour breakdown of the construction activities planned for the night shift. This level of detail ensures a comprehensive understanding of the sequence and timing of each task. The airport runway is scheduled to resume airline operations at 6 a.m. each morning after the contractor completes the night shift work.
